HIGHWAY ENGINEERING · PAVEMENT QA/QC

Granular Works
Construction Methodology & QA/QC

Practical highway engineering guidance for Granular Sub-Base (GSB), Wet Mix Macadam (WMM), granular pavement construction, material quality, compaction control, field testing and inspection documentation.

MoRTH-Oriented Guidance Site Execution Laboratory & Field Testing Inspection Documentation
GSB Granular Sub-Base
WMM Wet Mix Macadam
QA/QC Inspection & Testing
Excel Tools Mix Design Resources
GRANULAR WORKS LIBRARY

Explore Granular Construction Methodologies

Access practical construction guides, material quality references, compaction controls, inspection checkpoints and engineering resources for highway pavement works.

Explore the granular works resources below.
Pavement Foundation

Granular Sub-Base (GSB)

Material selection, grading, laying, moisture conditioning, compaction and field quality checks.

  • Subgrade readiness and setting out
  • Material grading and source quality
  • Spreading, moisture and compaction
  • Thickness, levels and acceptance checks
View GSB Methodology
Quality Control Reference

Test Frequency & Acceptance Criteria

A reference for planning material testing and reviewing granular-work quality records.

  • Material and gradation testing
  • Laboratory and field quality checks
  • Test frequency reference
  • Specification-based acceptance review
View QC Frequency PDF
Technical Articles

Granular Work Knowledge Base

Browse related HQT articles on granular pavement construction, compaction and field testing.

  • GSB and WMM technical articles
  • Field density and compaction topics
  • Practical highway QA/QC guidance
  • Related granular-work resources
Browse Granular Articles
Engineering Excel Tool

GSB Mix Design Toolkit

An Excel resource for documenting and reviewing GSB mix-design inputs and available calculations.

  • GSB mix-design documentation
  • Editable Excel workbook
  • Project-specific review support
  • Technical verification before use
View GSB Excel Toolkit
Engineering Excel Tool

WMM Mix Design Toolkit

An Excel resource for WMM mix-design documentation and review of supported workbook calculations.

  • WMM mix-design records
  • Editable Excel workbook
  • Material and calculation review
  • Project specification verification
View WMM Excel Toolkit
No matching resources found.

Try another keyword, such as GSB, WMM, QA/QC, compaction, field density or mix design.

FIELD EXECUTION SEQUENCE

Granular Work: From Approval to Acceptance

Follow the applicable construction sequence, approved method statement, drawings, project specifications, Quality Assurance Plan (QAP) and Inspection and Test Plan (ITP).

01

Pre-Construction Approval

Verify drawings, approved materials, method statement, mix-design documents where applicable, QAP, ITP and equipment readiness.

02

Underlying Layer

Check readiness, surface condition, line, level, width, cross-fall and the required inspection approval.

03

Material & Laying

Control material quality, gradation, handling, segregation, spreading, layer thickness and moisture.

04

Compaction & Testing

Follow the approved rolling procedure and complete specified field-density and other QC checks.

05

Geometry Checks

Verify finished levels, width, cross-fall, compacted thickness and surface regularity against requirements.

06

Rectification

Identify non-conformities, correct defective areas using an approved procedure and arrange retesting as required.

07

Quality Records

Compile test reports, survey records, inspection requests, material approvals and applicable checklists.

08

Layer Acceptance

Offer the completed layer for inspection and obtain the required approval before the next construction activity.

Engineering note: GSB and WMM are different pavement layers with different material, production and acceptance requirements. Do not apply one compaction criterion, layer thickness, test frequency or tolerance to every granular activity. Verify the applicable contract provisions, MoRTH specifications, approved ITP/QAP and Engineer's instructions.
QUALITY ASSURANCE & CONTROL

Key QA/QC Checkpoints for Granular Works

Plan inspections and testing around the particular pavement layer, approved project requirements and applicable acceptance criteria.

Material Quality & Gradation

Review source approval, sieve analysis, specified aggregate properties, cleanliness and conformity with the approved grading envelope.

Moisture & Compaction

Verify the applicable laboratory compaction reference, field moisture condition, rolling procedure and specified field-density requirements.

Thickness & Geometry

Check compacted thickness, finished levels, width, cross-fall and surface regularity against approved drawings and applicable tolerances.

Plant & Equipment

For WMM, verify plant readiness, proportioning and mixing controls, transportation, laying equipment and the approved construction procedure.

Defect Prevention

Monitor segregation, loose material, rutting, soft spots, uneven surfaces and drainage issues. Rectify non-conformities before acceptance.

Documentation & Approval

Maintain applicable material reports, test results, survey checks, inspection requests, calibration records and layer-approval documents.

PRACTICAL ENGINEERING RESOURCES

Granular Work Excel Tools & References

Explore material-specific workbooks and technical references to support granular-work documentation and QA/QC review.

GSB Mix Design Excel

GSB mix-design documentation and workbook resources.

Explore →

WMM Mix Design Excel

WMM mix-design documentation and workbook resources.

Explore →

GSB, WMM, CTGSB & CTB Bundle

Explore the combined granular and cement-treated material QA/QC toolkit.

View Bundle →

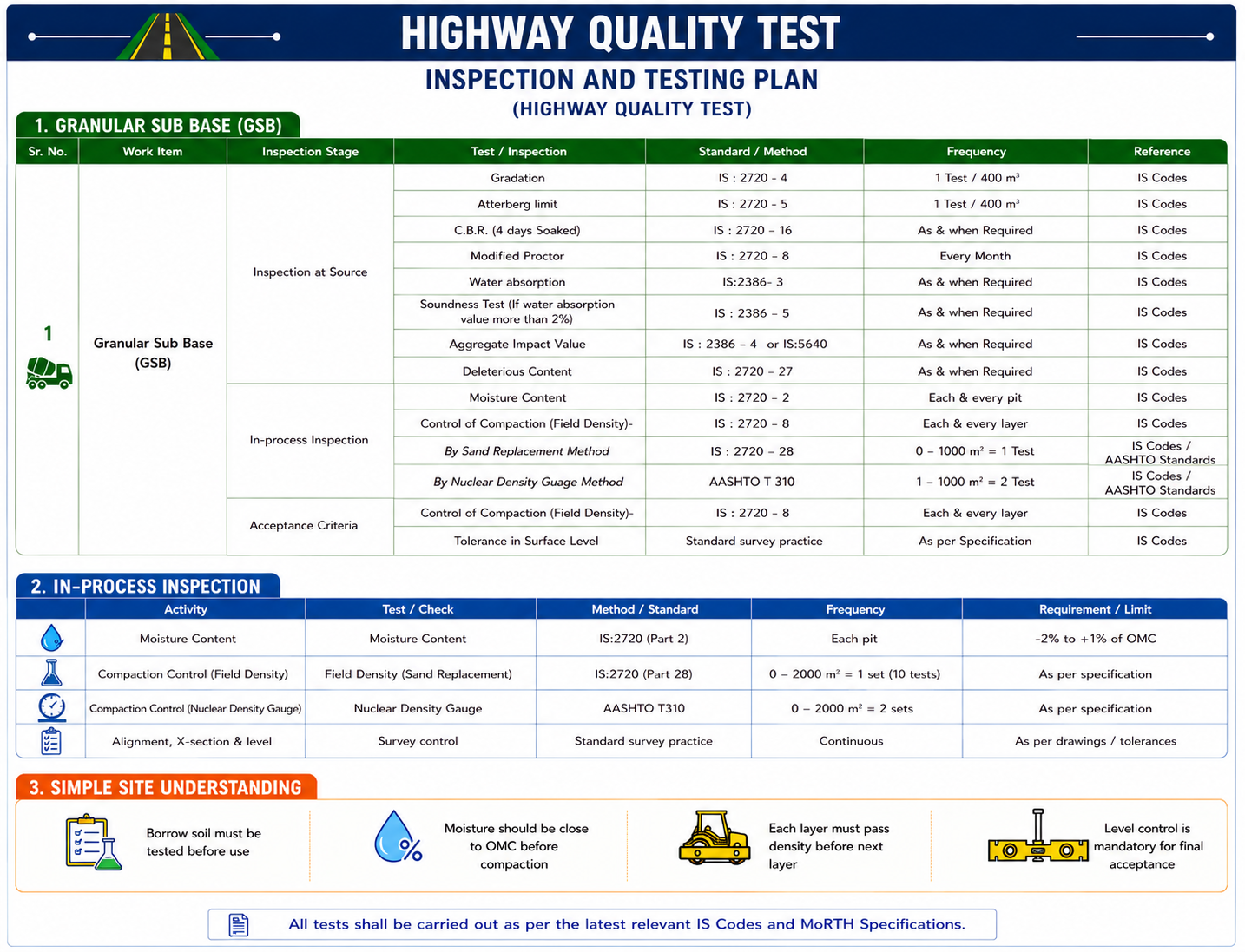

Quality Control Test Frequency PDF

A reference for test planning and acceptance review.

Open PDF ↗
HIGHWAY CONSTRUCTION KNOWLEDGE

Granular Works Construction Methodology for Highway Projects

Granular works are an important part of flexible pavement construction. Granular Sub-Base (GSB) provides a foundation layer with specified support and drainage characteristics, while Wet Mix Macadam (WMM) is used as a granular pavement layer in accordance with the applicable pavement design and contract requirements.

Proper construction requires control of material properties, grading, layer placement, moisture conditioning, compaction, thickness, finished levels and surface quality. Inspection and testing should be planned before work starts and carried out in accordance with the approved Inspection and Test Plan (ITP), Quality Assurance Plan (QAP), applicable MoRTH Specifications and project-specific requirements.

GSB Construction Methodology and Quality Control

GSB construction begins with verification of the prepared underlying layer, approved material sources and specified grading requirements. The material is spread to the required profile, moisture-conditioned where required, compacted and checked for thickness, levels, width and other specified acceptance parameters. Material properties and field tests must meet the applicable project requirements.

Read the dedicated GSB Construction Methodology for more detailed guidance.

WMM Construction Methodology and Quality Control

WMM construction involves control of aggregate grading, approved material proportions, plant mixing, moisture, transportation, laying and compaction. Site personnel should check plant operations, uniformity of the mix, segregation, laying thickness, rolling sequence and completed-layer geometry. The specified field tests and inspections must be completed before the layer is offered for acceptance.

Read the dedicated WMM Construction Methodology for further details.

Why Granular-Work Quality Control Matters

Inadequate material control, segregation, poor moisture management, insufficient compaction and geometric irregularities can adversely affect pavement performance. Systematic inspection, documented test results and timely correction of non-conformities help establish consistent construction quality and support formal layer acceptance.

Test Frequency and Acceptance Requirements

Test selection, frequency, sampling arrangements and acceptance criteria should be taken from the applicable contract, MoRTH specifications, approved ITP/QAP and Engineer's instructions. A general reference should not be treated as a substitute for project-specific requirements.

Who Should Use This Resource Hub?

This hub is intended for highway site engineers, QA/QC engineers, materials engineers, laboratory technicians, survey teams, contractors and consultants who need practical access to granular-work methodology, inspection checkpoints, testing references and engineering resources.

COMMON ENGINEERING QUESTIONS

Granular Works FAQs

What is covered under granular works in highway construction?
This hub focuses primarily on Granular Sub-Base (GSB) and Wet Mix Macadam (WMM), including material quality, laying, moisture conditioning, compaction, field testing, geometry checks and quality documentation.
What is the difference between GSB and WMM?
GSB is a granular sub-base layer constructed over the prepared formation. WMM is a mechanically mixed granular pavement layer constructed using graded aggregates and water. Their material requirements, construction procedures and acceptance criteria differ and must be checked against the applicable specifications.
Which tests are relevant to GSB and WMM?
Depending on the material and applicable specification, tests may include grading, specified aggregate-property tests, moisture content, laboratory compaction, field density and checks for layer thickness, levels, width and cross-fall. Use the approved ITP/QAP for the exact test list and frequency.
Where can I find the GSB and WMM construction procedures?
Can these resources be used for project inspection and acceptance?
They can support technical understanding and inspection planning. Final acceptance must be based on the contract, approved drawings, applicable specifications, approved ITP/QAP, test results and the Engineer's formal approval.
Are mix-design Excel workbooks a substitute for approved designs?
No. Excel workbooks are calculation and documentation aids. Verify their inputs, formulas, units and outputs, and use them alongside approved mix designs, laboratory results and project-specific technical requirements.
Where should granular-work test frequencies be checked?
Refer to the applicable contract and MoRTH specifications, together with the approved ITP/QAP and Engineer's instructions. Confirm the applicable test, sampling frequency and acceptance criterion before starting the activity.
HIGHWAY QUALITY TEST

Build Better Granular Work QA/QC Practices

Explore practical construction methodologies, material testing references and Excel resources for highway pavement construction.
